Roadworks
Check the schedule construction site for the next three months on the CAV network
>> Construction sites open and planned for the week of 26.01.2026 to 01.02.2026
>> Construction sites open and planned for the week of 19.01.2026 to 25.01.2026
>> Construction sites open and planned for the next three months

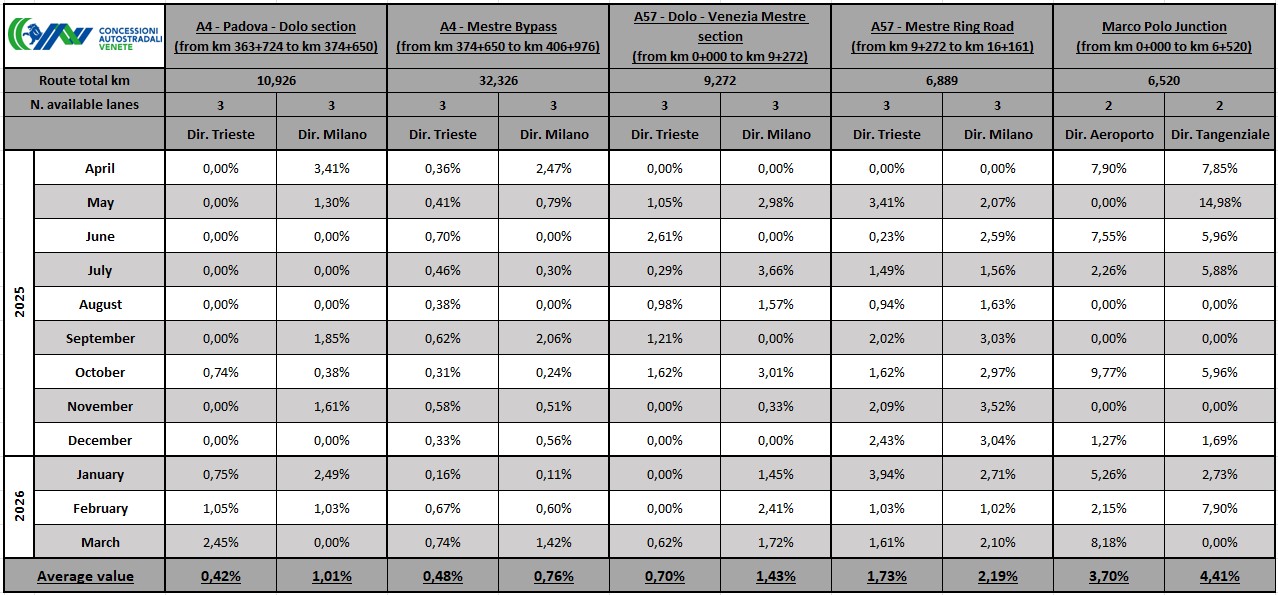

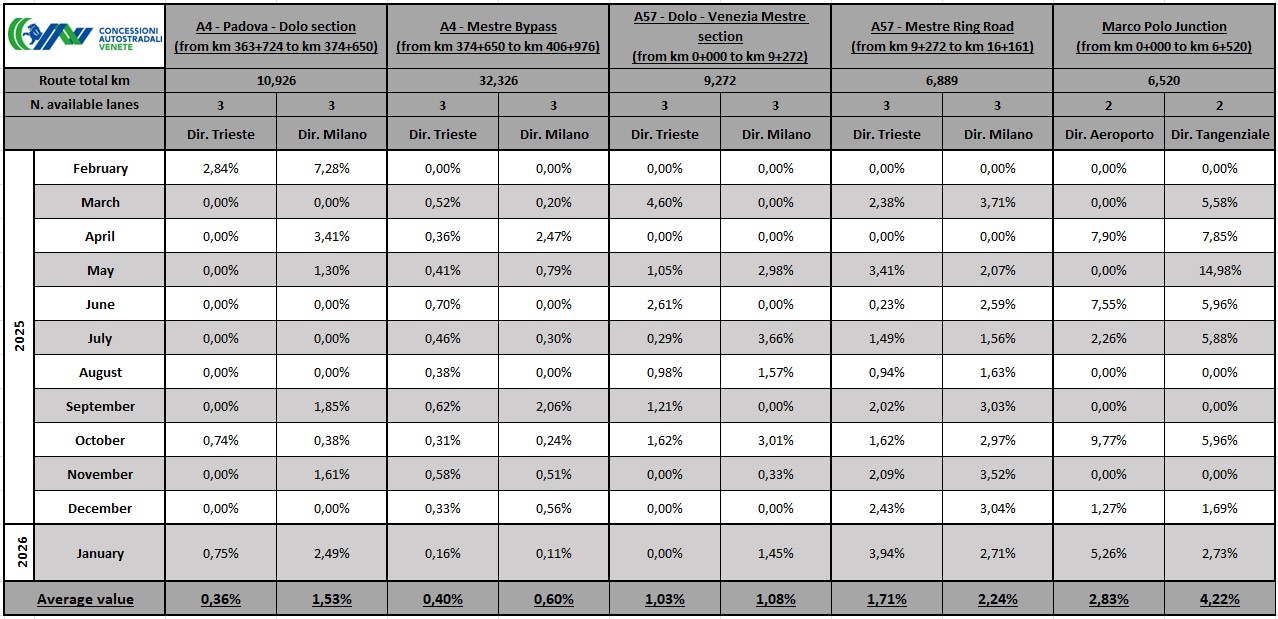

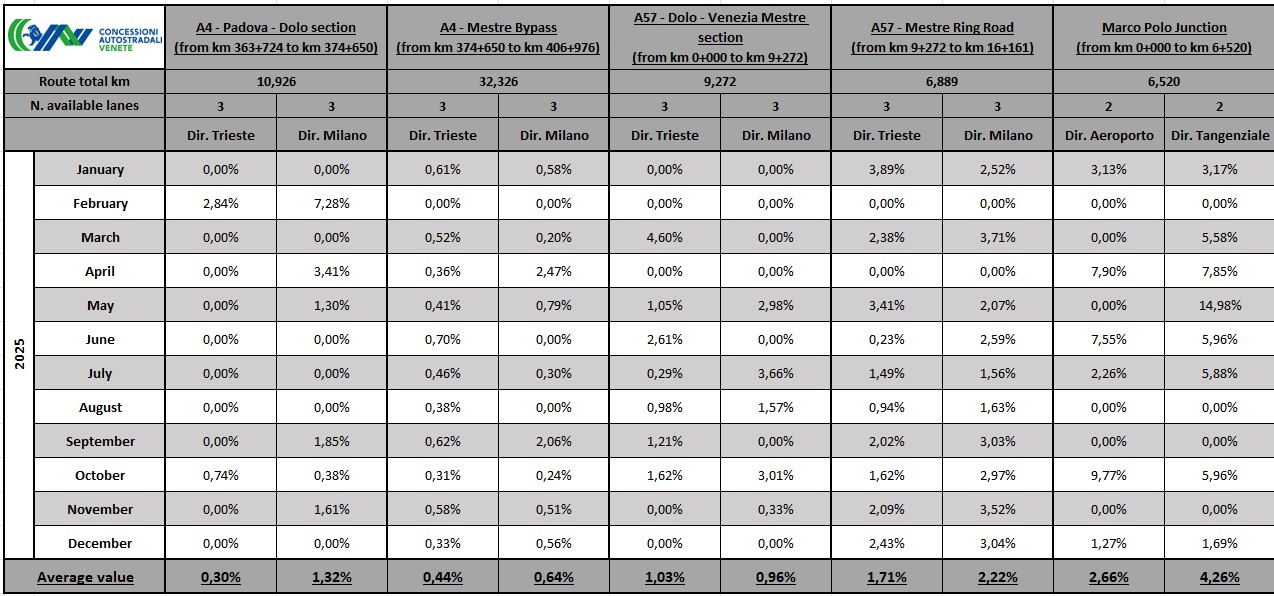

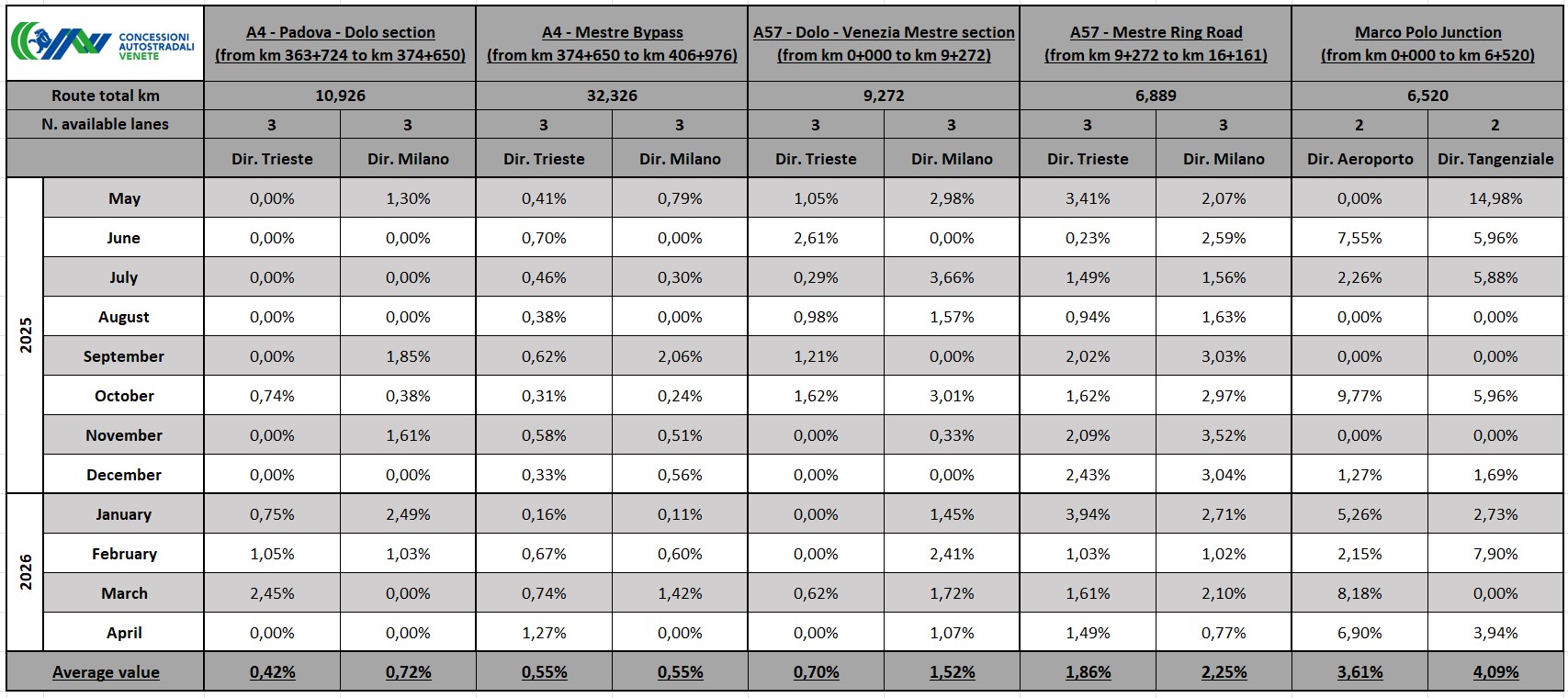

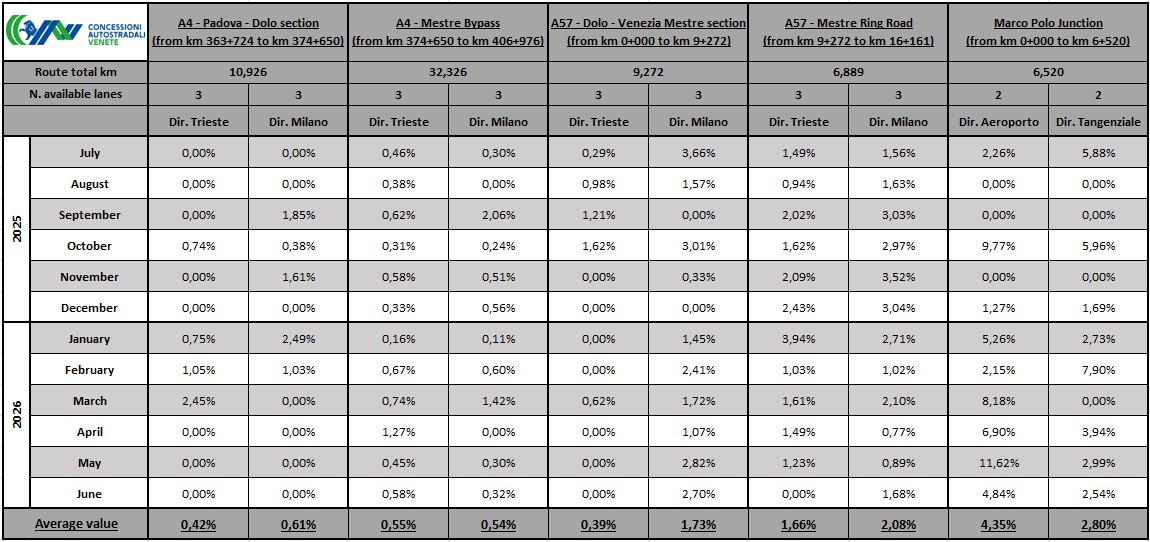

Percentage impact of road construction sites calculated as the ratio between the kilometers of lanes that are unavailable and the kilometers of lanes available to traffic in the absence of road construction sites, weighted in terms of time. This index is calculated as the monthly average of the last 12 months for fixed, not removable road construction sites carried out during daytime hours (6 a.m. to 10 p.m.).
